Article

Your deposit does not go to the developer

It goes into a project-specific account the developer can only draw from when an independent party certifies construction progress. Here is how release…

· 6 min read

[Get the free escrow guide] [Verify a project before you pay]

The Dubai material on this page comes from primary statutes. The Abu Dhabi material comes from legal analysis rather than the instruments themselves, and is marked as reported. Not legal advice.

Trust bar

AED 500,00020%5%
penalty for a developer failing to open or deposit into escrow, under Executive Council Resolution No. 25 of 2009construction completion before an Abu Dhabi developer can draw from escrowstatutory retention held for a year after completion under Article 14
The wrong account

The problem

The most common way money is lost in UAE off-plan is not a developer failing.

It is a payment made into an account that was never the escrow account. The request is usually framed as a favour: pay direct and skip the admin, or take a small discount for doing it. Lawyers who handle these cases describe it as a pattern, not an exception.

Escrow only protects money that went into it. Everything else on this page is secondary to that one sentence.

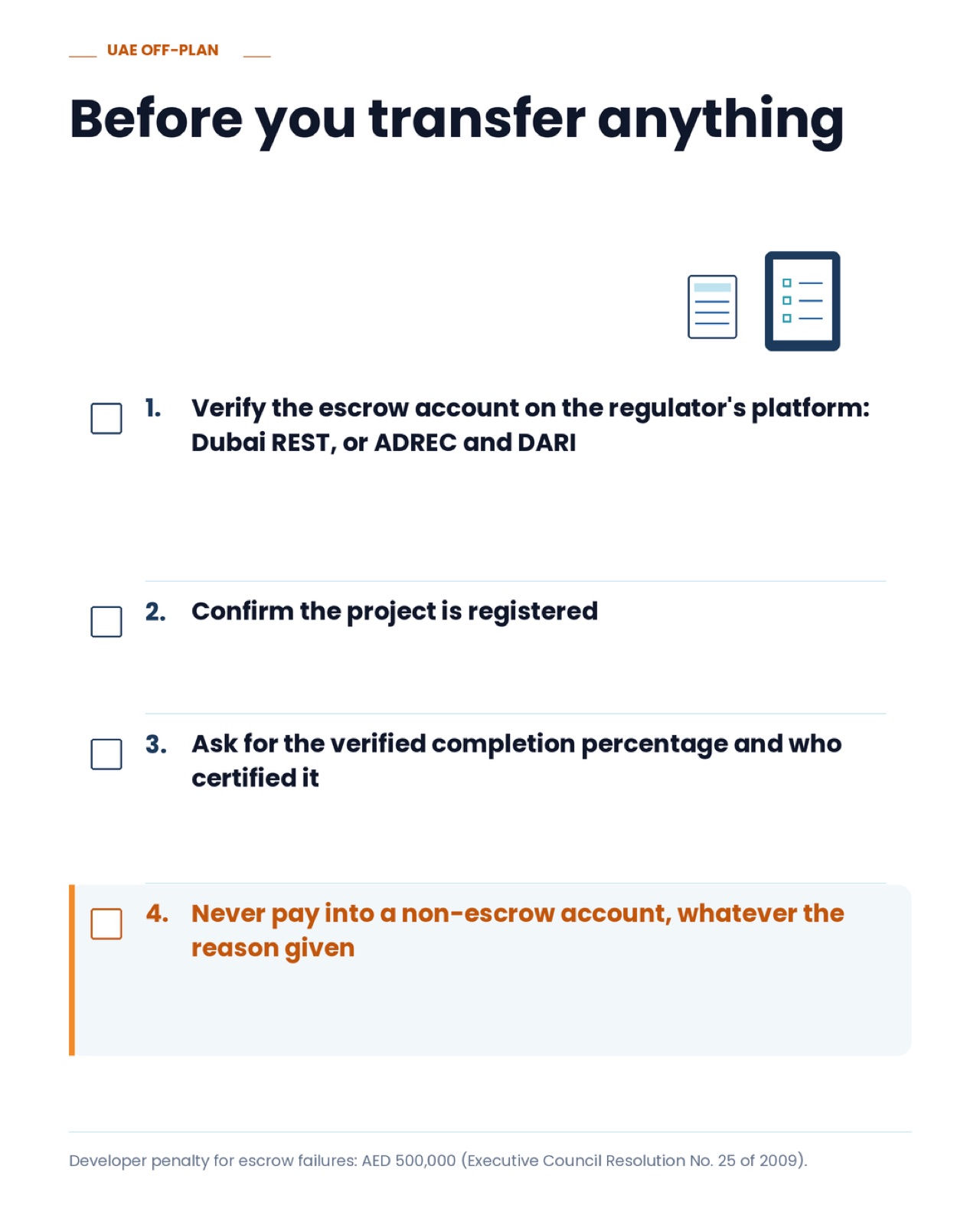

Before you transfer anything

What escrow does and does not do

What it does.

Project specificity. The account belongs to one project. Deposits on project A cannot fund project B.

Creditor ring-fencing. Under Article 9 of Dubai Law No. 8 of 2007, escrow funds are protected from the developer's general creditors. If the wider business fails, that money is not available to unrelated debts. This is the most underrated protection in the system.

Controlled release. The developer cannot withdraw on request. Release requires independent certification of progress and regulator approval before the trustee bank disburses.

What it does not do.

It does not guarantee the project completes. It does not guarantee a handover date. It does not refund you for changing your mind. It does not certify quality, only progress. And it does not cover a single dirham paid outside it.

💡 INLINE CTA #1
The six checks to run before you transfer anything.
Free guide, 34 pages, source-graded. No call required.
[Send me the guide]
How money leaves escrow

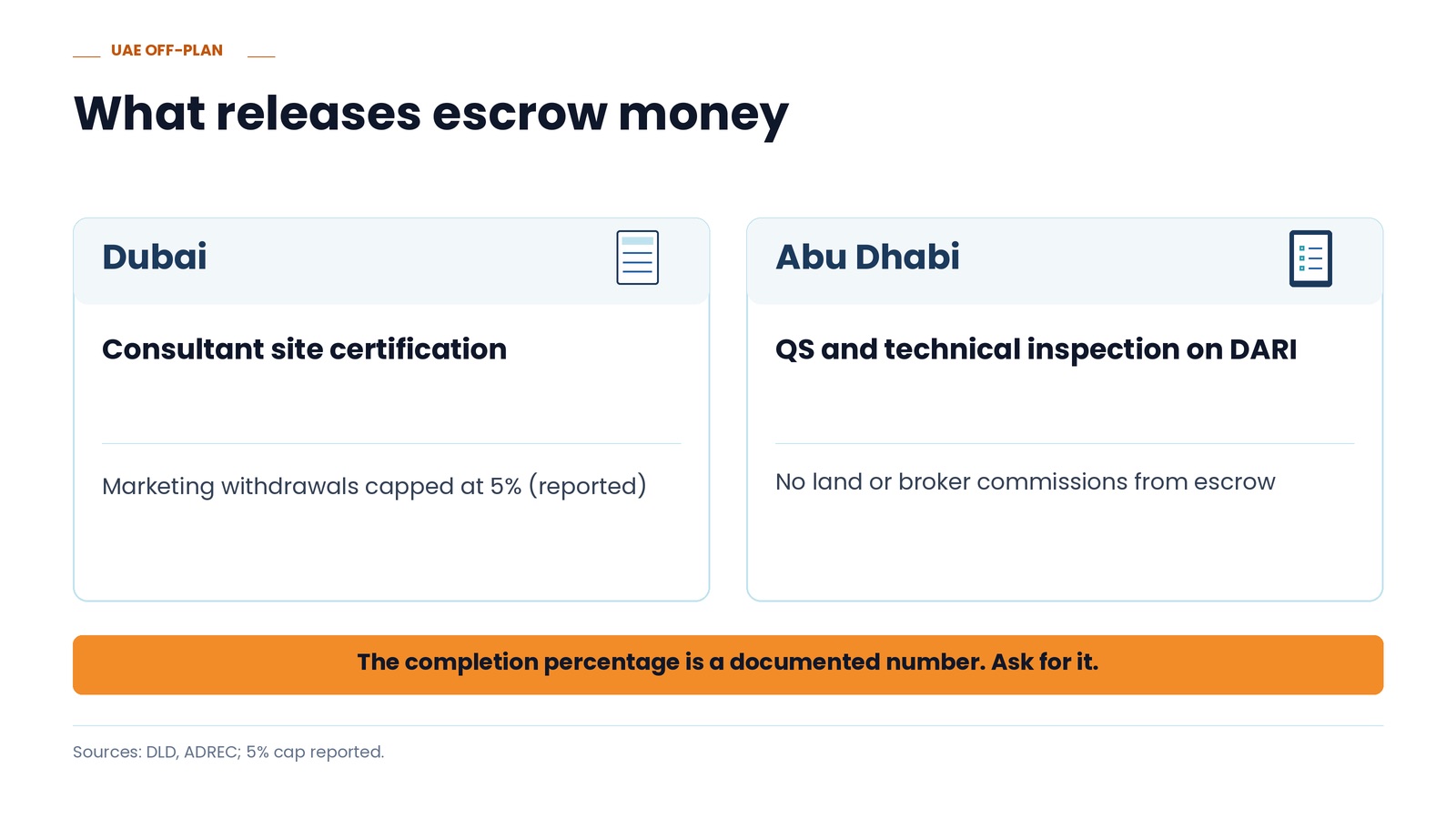

What releases escrow money

How release is triggered

Money leaves escrow against certified progress, not against a developer's invoice.

Dubai: consultant site certification, with the land department increasingly using technology-assisted verification alongside paper certification.

Abu Dhabi: quantity surveyor reports and DMT technical inspection, logged into the DARI portal.

The buyer-relevant consequence of that is simple and useful. If release depends on a certified completion percentage, then that percentage is a document rather than a sales estimate. Asking for it, and for who certified it, is a fair question with a real answer.

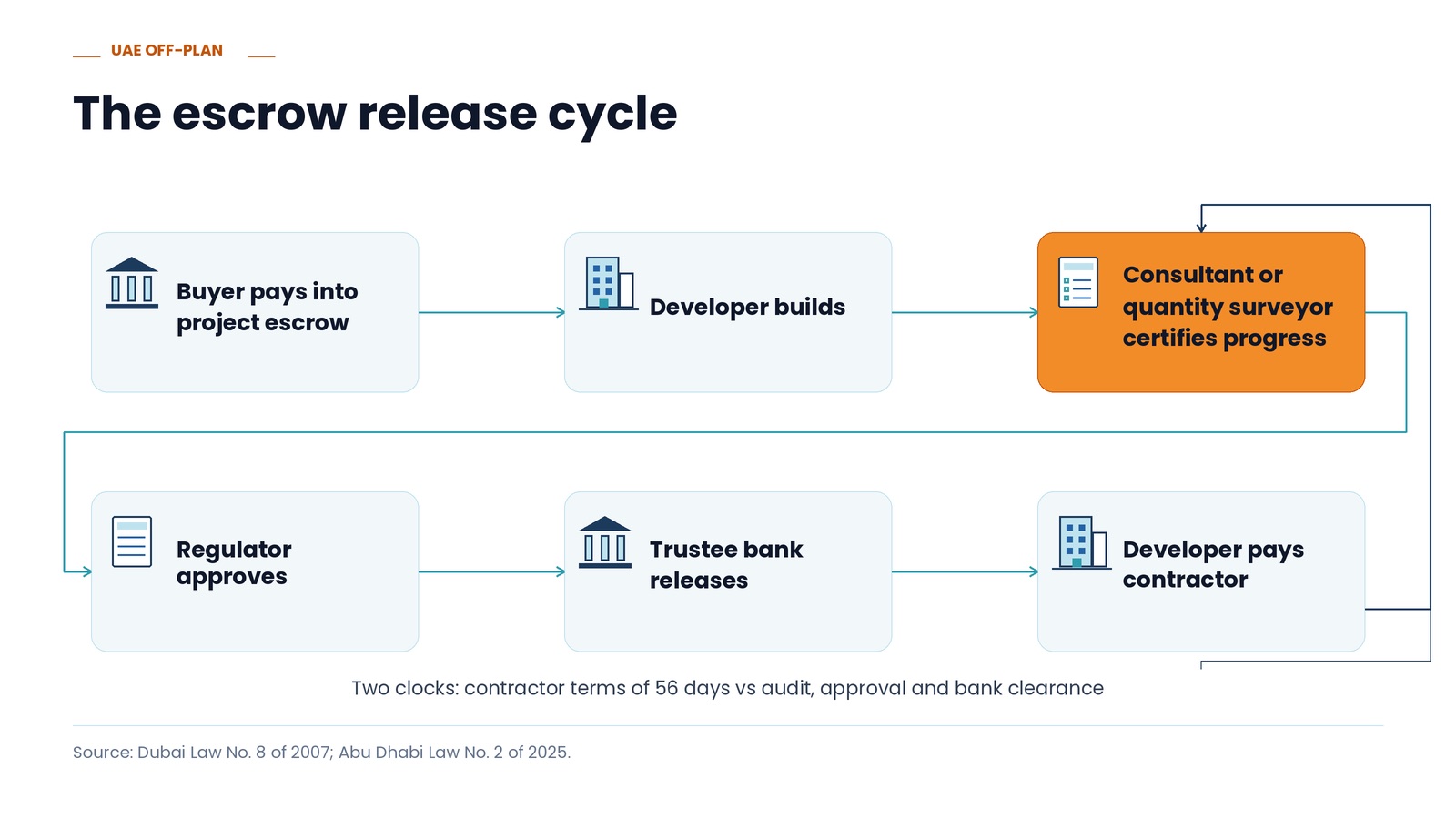

The release cycle

Dubai vs Abu Dhabi

DubaiAbu Dhabi
StatuteLaw No. 8 of 2007Law No. 3 of 2015 as amended by Law No. 2 of 2025
RegulatorDLD and RERAADREC under DMT
Drawdown barReported at 20% physical completionStatutory bar before 20% completion
Early accessReported 30% gate to register and sell20% unconditional bank guarantee, reported locked until 60% progress
Verification for buyersDubai RESTADREC and DARI
Prohibited usesMarketing withdrawals reported capped at 5%Land acquisition and broker commissions prohibited
Retention5% under Article 14, released one year from unit registration5% of total project value, reported released one year from Building Completion Certificate
💡 INLINE CTA #2
Before the transfer, not after.
Send us the project. We confirm registration, verify the escrow account on the regulator's own platform, pull the current verified completion percentage, and check the contractual handover date in the SPA against the marketed quarter.
[Verify a project]
The 20% guarantee lock

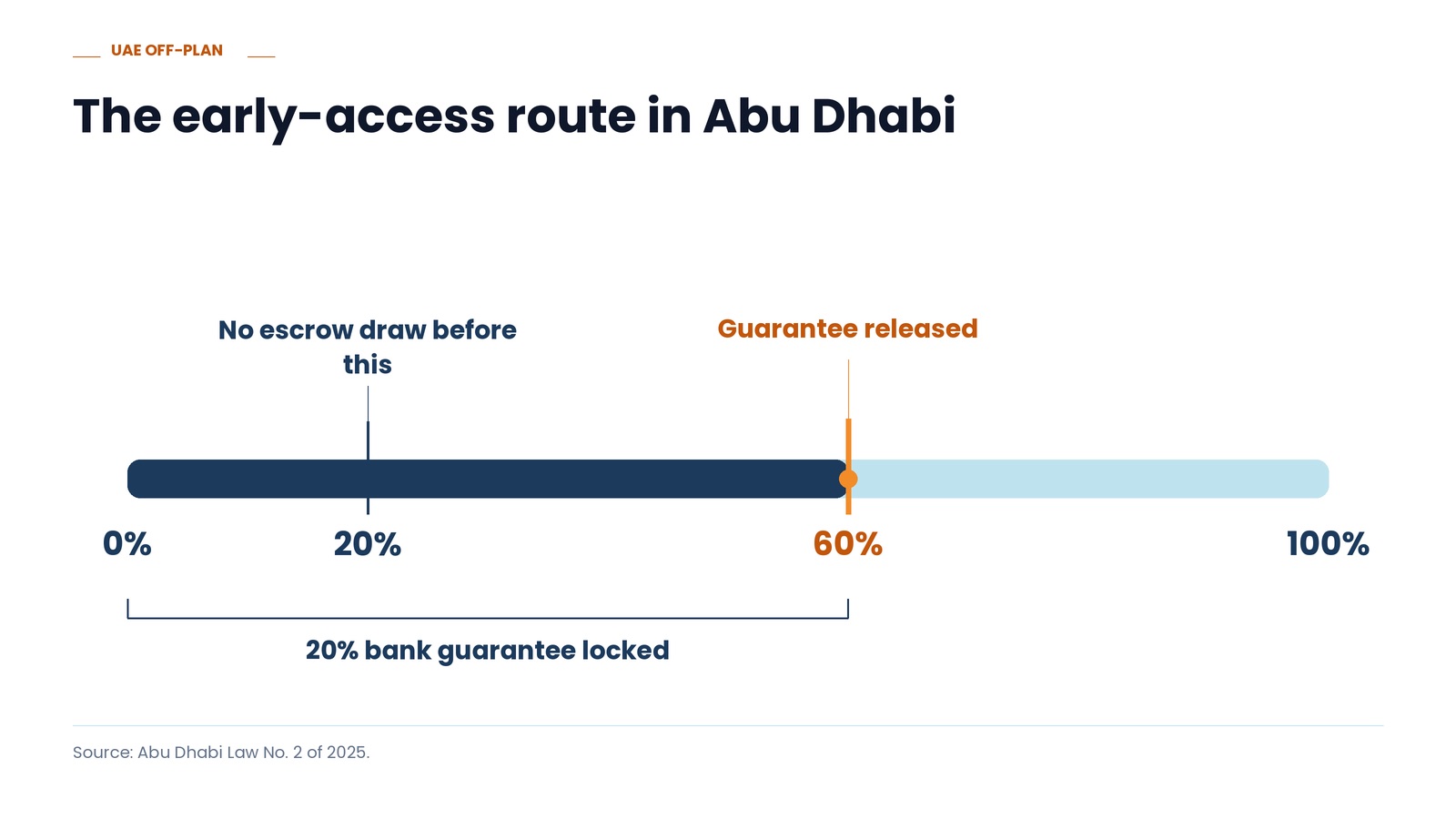

The early-access route in Abu Dhabi

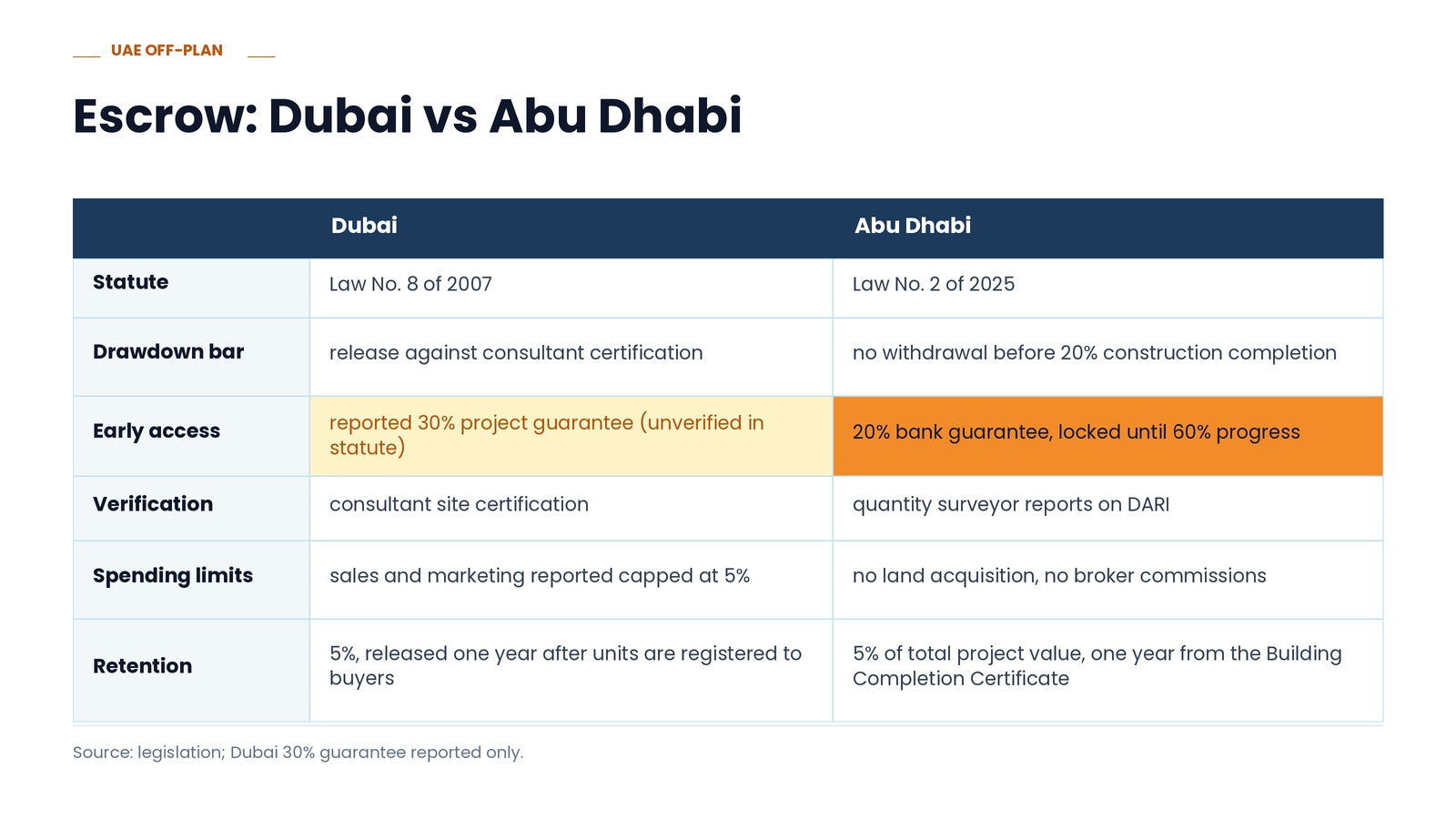

Dubai vs abu dhabi escrow
Escrow: Dubai vs Abu Dhabi

Paying outside escrow

⚠️ If anyone asks you to pay to an account other than the registered project escrow account, stop.
It does not matter how the request is framed, and the discount version is the most dangerous version because it makes the buyer feel clever. Dubai's own fines schedule sets AED 500,000 for a developer who fails to open an escrow account or to deposit into it, and AED 100,000 for an escrow agent who breaches disbursement rules. Those penalties exist because this is the failure the regulator most wants to prevent.
Verify the account on the regulator's platform. A developer who objects to you verifying has answered your question.
The escrow release cycle

The six checks

1. Confirm the project is registered. Dubai REST, or ADREC and DARI. An unregistered project is a stop, not a negotiation.

2. Verify the escrow account on the platform, not on paper. Compare the regulator's record against what you were sent. A one-digit difference is the whole risk.

3. Ask for the current verified completion percentage and who certified it. Release depends on it, so it exists.

4. Ask which drawdowns have been made against that percentage. The reaction to this question is informative even when the answer is not given.

5. In Abu Dhabi, ask which escrow route the project is on. If the developer drew before 20%, there is a 20% bank guarantee with the regulator, reported to stay locked until 60% progress. That tells you how much of the developer's own capital is committed.

6. Check the contractual handover date in the SPA against the marketed quarter. Only one of them has legal consequences.

💡 INLINE CTA #3
We run all six before any client of ours transfers anything.
It takes an afternoon and it is the cheapest risk reduction available in this market.
[Verify a project]
Before you transfer anything

FAQ

How do I verify a Dubai escrow account?

Through the Dubai REST app, the Dubai Land Department's own platform. Verify there rather than relying on documents from the developer or agent.

Can a developer withdraw from escrow whenever they want?

No. Release requires independent certification of construction progress and regulator approval. In Abu Dhabi there is a statutory bar on drawdowns before 20% completion.

What happens to my money if the project is cancelled?

Where the regulator cancels a project, no retention applies and funds are refunded through the escrow liquidation mechanism. In Dubai, jurisdiction over cancelled projects sits with the Special Tribunal under Decree No. 33 of 2020.

When is the 5% retention released?

Article 14 of Law No. 8 of 2007 provides for a 5% retention held one year post-completion, with the trigger described in our research as one year from registration of units in purchasers' names. Abu Dhabi's equivalent is reported as one year from the Building Completion Certificate.

Does escrow guarantee my money back?

No. It controls what the money can be spent on and who may release it, and ring-fences it from the developer's general creditors. It is not insurance against delay or non-delivery.

What if the developer asks me to pay direct?

Do not. Verify the escrow account on the regulator's platform and pay only into it.

Before you transfer anything

Final CTA block

Not ready to talk. Take the 34 page guide, including the six checks as a letter you can send and the red flag card.

[Send me the guide]

About to transfer. Send us the project. We verify before the money moves.

[Verify a project]

Conversion notes

  • The verification offer should convert unusually well on this page because the trigger is an imminent payment. Expect CTA #2 and #3 to outperform the download, which is the reverse of the usual pattern, and track it.
  • The warning block is the shareable. Give it its own anchor.
  • The confidence note at the top is a differentiator, not a hedge. No competing page in this category distinguishes primary statute from legal analysis and it costs nothing to say.
  • Name and email only on the download.
  • One exit-intent modal, offering the red flag card alone.
  • Do not soften the "a developer who objects has answered your question" line. It is the sentence people will repeat.

Looking at a specific project?

Every brochure, factsheet and floor plan is readable in-page, priced live in AED and in crypto.

Browse projectsRun the calculatorsMore insights

New launches, first

Allocations land here before they go public.

Launch pricing, payment plans and the full document pack, sent the day they reach our desk. No spam, and one unsubscribe link.
